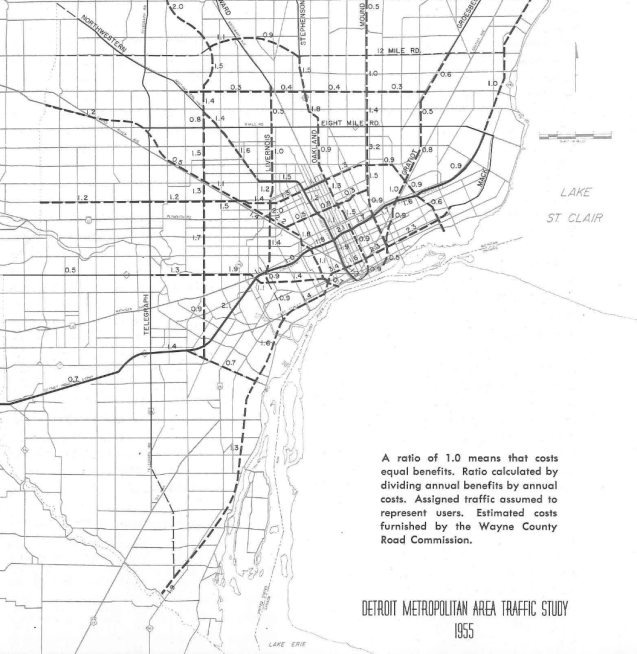

Map: Detroit Highway Construction Benefit Cost Ratio 1955

Screen Shot 2017-10-18 at 8.11.08 AM

This map is included in Part 2 of the Detroit Metropolitan Area Traffic Study of 1955 by the Michigan State Highway Department. You can see I-94 and the M-10 Lodge Freeway were already complete, but considerations were being made to expand and add more highways. On page 118, it notes:

“Yet there are considerations of land costs; of property removal; of financial responsibility; of classes of trips with relatively greater need; and of public acceptance and rapidity of possible building.”

Not enough weight was given to the consideration of racially disproportionate impacts and wholesale destruction of Detroit’s Black community center where I-75 now lies.

Interestingly the highway proposed along Jefferson Avenue has ratios of 2.3 for every segment making it the highest benefit cost ratio on the map, yet was a highway that was never built. The outcome of that can be seen in the 1968 map of “Where communters run over Black children on the Pointes-Downtown track.” What if that highway had been built?





Leave a Reply

Fill in your details below or click an icon to log in:

WordPress.com Logo

You are commenting using your WordPress.com account. Log Out /  Change )

Facebook photo

You are commenting using your Facebook account. Log Out /  Change )

Connecting to %s
